Status of implementation of the four major and medium irrigation projects in Kerala
|
Name of Project
|
Districts Covered
|
Year of Commencement
|
Targeted Gross area
(in ha)
|
Muvattupuzha Valley irrigation project
|
Ernakulum, Idukki
|
1974
|
35619
|
Idamalayar irrigation Project
|
Ernakulam, Idukki, Thrissur
|
1981
|
29036
|
Karapuzha Irrigation Project
|
Wayanad
|
1978
|
8721
|
Banasurasagar Irrigation Project
|
Wayanad
|
1979
|
3825
|
Source: Technical committee report on major and medium irrigation projects, KSPB
|
Details of ongoing Major and Medium Irrigation Projects in Kerala is given here.

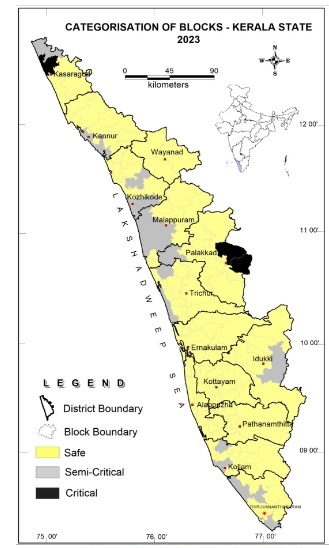

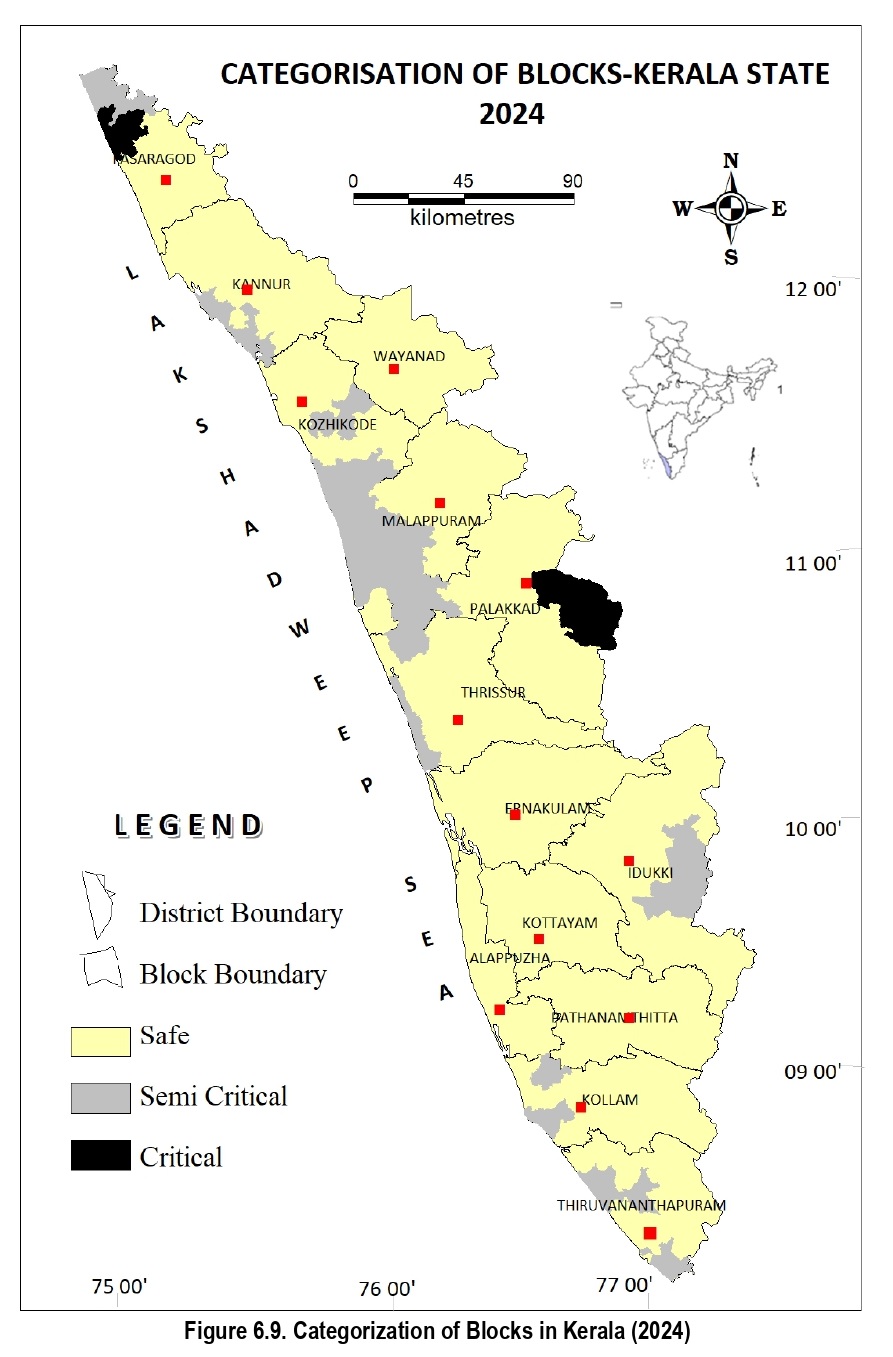

Categorization of Blocks
As per 2013 reports, the assessment units have been categorized as “Over-exploited”, “Critical”, “Semi-critical” or “Safe” on the basis of Stage of Ground Water Development and the long-term decline of average ground water levels in the observations wells in the assessment unit, as per the criteria suggested in GEC-1997 methodology. Decline of ground water levels of 15 cm per year or more has been considered significant in the State while categorizing the blocks. However, in such units where the monsoon recharge has been computed by ad-hoc method on account of the water level data not being representative, categorization has been done primarily on the basis of stage of development and the existing ground situation. Out of 152 assessed units in the State, Chittur block of Palakkad district has been categorized as ‘Over-exploited’ and 2 blocks (Kasargod block of Kasargod district and Malampuzha block of Palakkad district) have been categorized as “Critical”. Out of the remaining blocks, 18blocks are “Semi-critical” and 131 blocks are “Safe”.
• Groundwater Resource computations have been made for 152 assessment units (blocks) spread across 14 districts of the State. In addition to that, the ground water resources of urban habitation comprising 6 Municipal Corporations, 87 Municipalities and 1 Township have been combined with the adjoining blocks based on their hydro geological setup.
• According to the new GEC methodology (2015), the criteria of categorization of assessment unit are as follows:
|
Sl No
|
Stage of groundwater extraction
|
Categorization
|
1
|
<=70%
|
Safe
|
2
|
>70% and <=90%
|
Semi- Critical
|
3
|
>90% and <=100%
|
Critical
|
4
|
>100%
|
Over Exploited
|
Stages of Groundwater Development | Categorisation of blocks Kerala as on march 2013

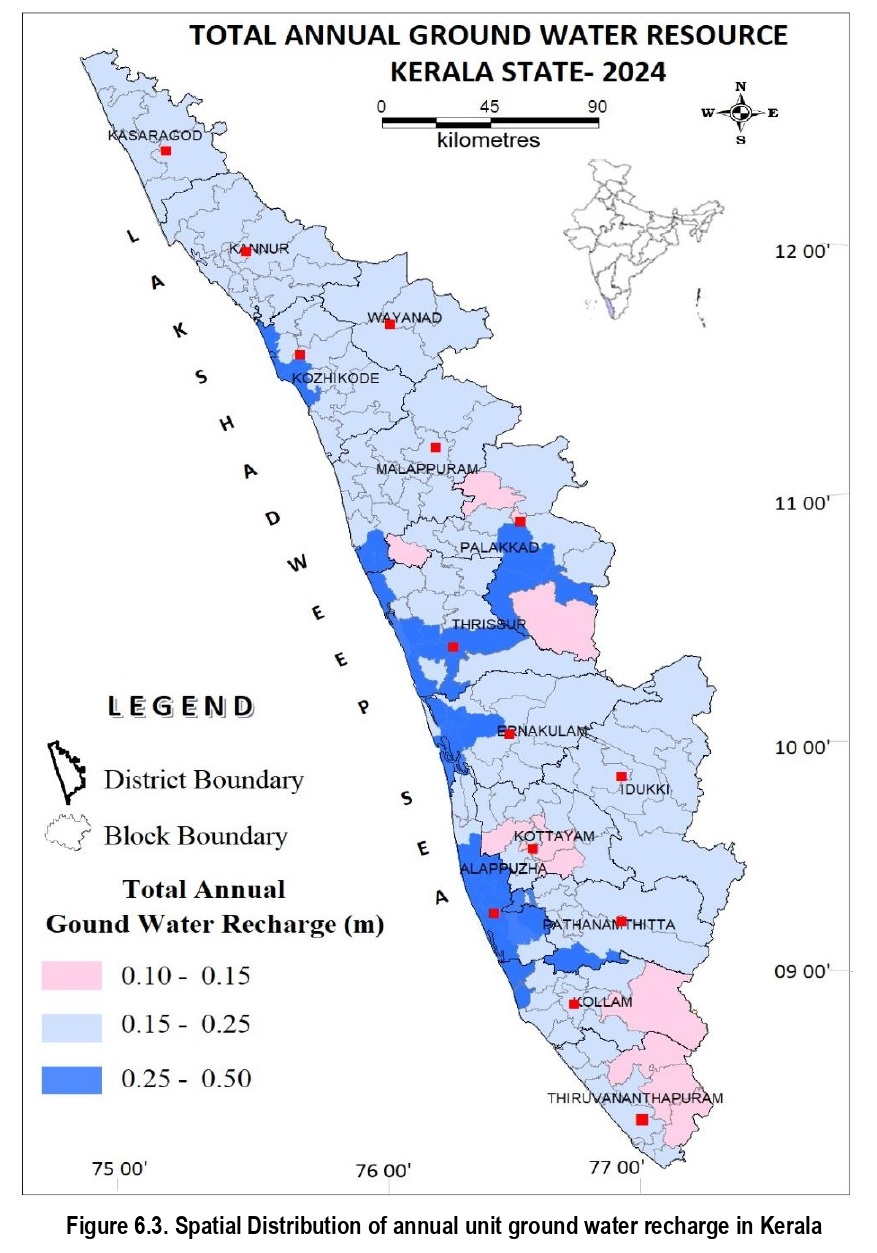

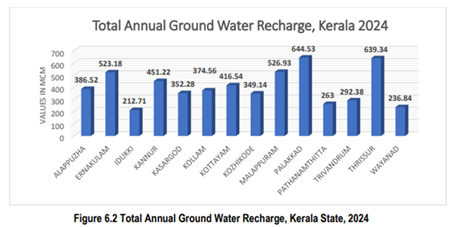

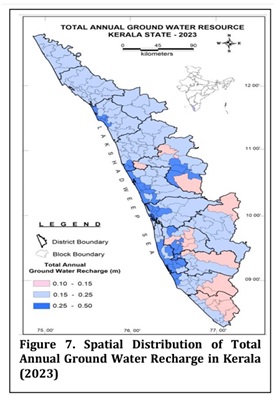

Net Ground Water Availability for the entire State
|

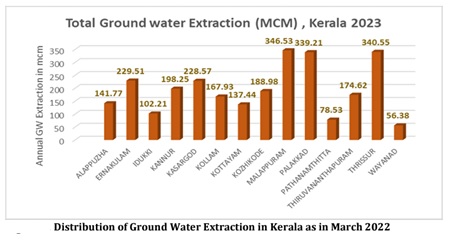

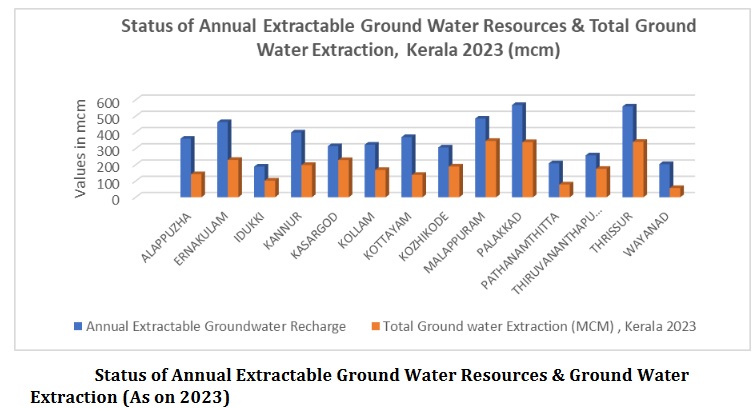

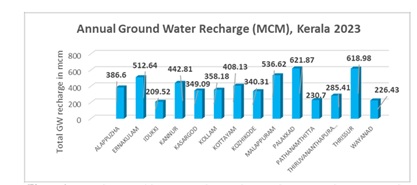

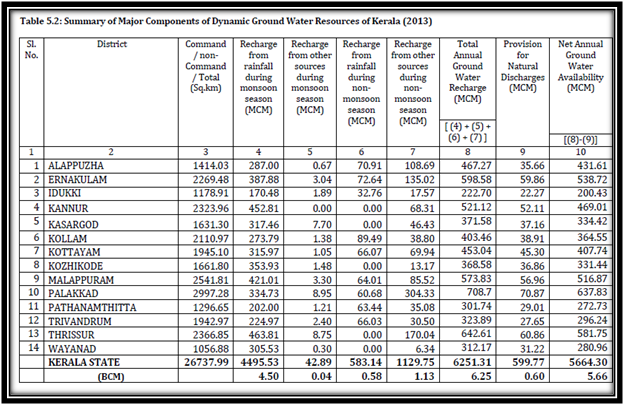

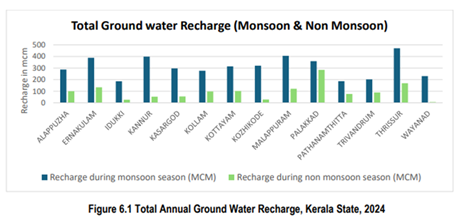

5211.75 MCM (ranges from 186.14 MCM in Idukki district to 591.44 MCM in Palakkad district).
|

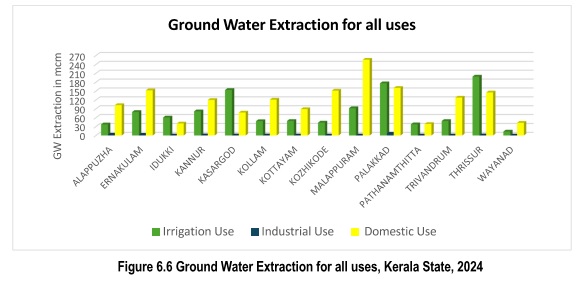

The Annual Ground Water Extraction for all uses
|

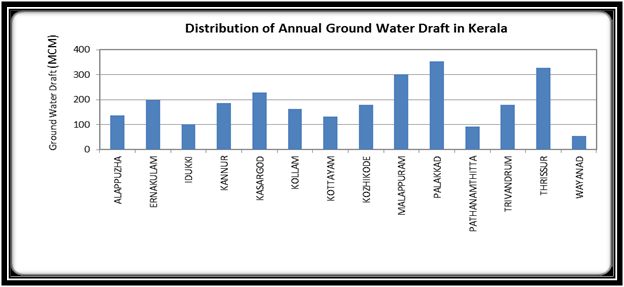

2672.09 MCM (ranges from 56.78 MCM in Wayanad district to 340.56MCM in Thrissur)
|
The Annual Ground Water Allocation for Domestic use up to 2025
|
1571.28 MCM (ranges from 38.06 MCM in Wayanad district to 254.99 MCM in Malappuram)
|
The Net Ground Water Availability for future
|
2408.29 MCM (ranges from 77.48 MCM in Idukki district to 267.10 MCM in Alappuzha district).
|

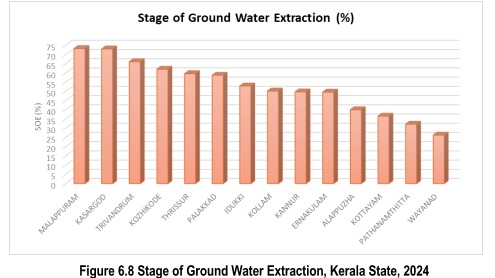

The Stage of ground water extraction of assessment units
|

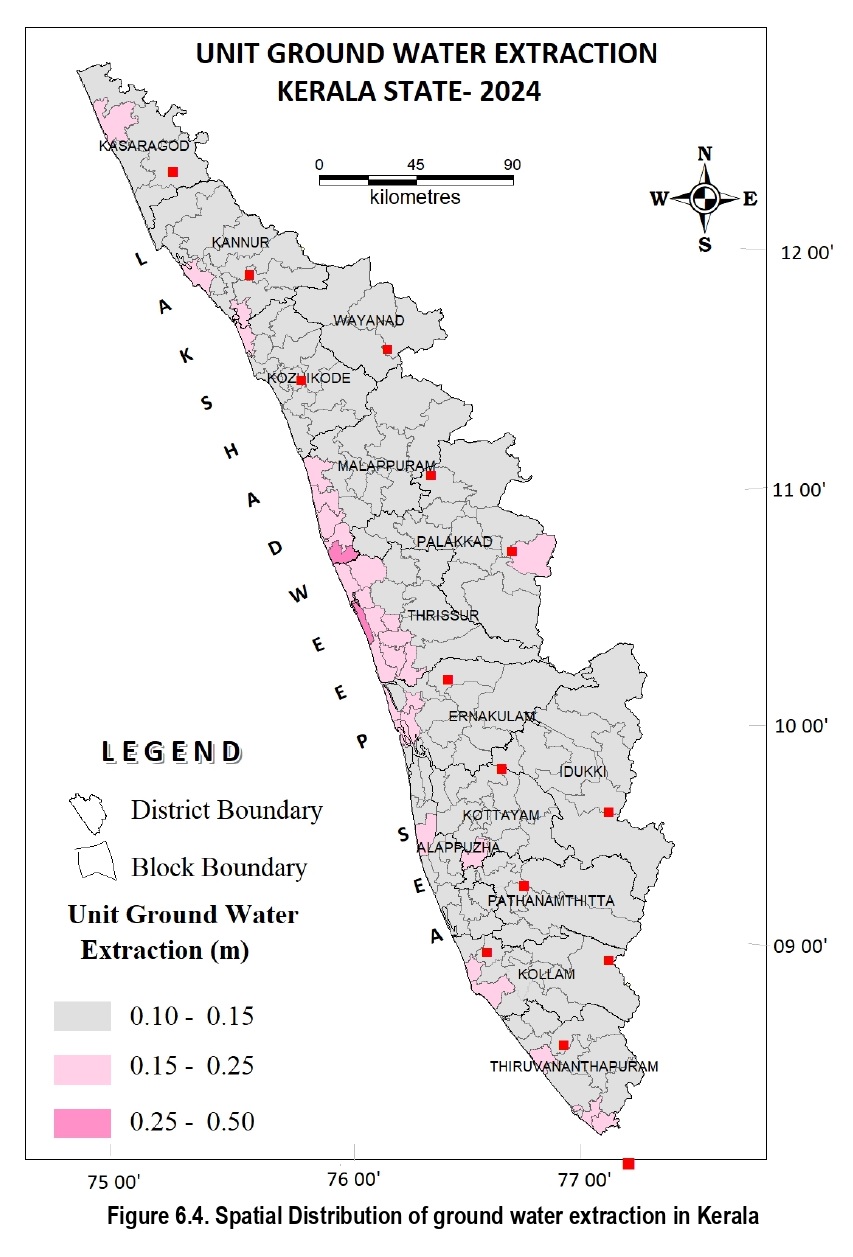

51.27 % for the State (highest in Kasargod district (79.64%) and the lowest in Wayanad district (24.51%).
|

Depth to Water Levels

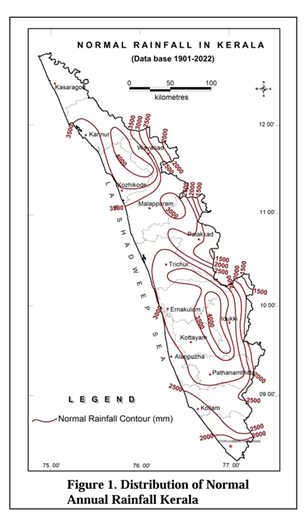

The depth to water level was monitored from 1006 monitoring wells distributed throughout the State during the months of April, August, November and January. The water level measured during the month of April is taken as pre-monsoon water level and the data of November is taken as post-monsoon water level, on the basis of temporal distribution of long-term rainfall in the State. The depth to water level mostly depends on the hydrogeological conditions of the area as well as topography, rainfall pattern, etc. In coastal plains the depth to water level is generally restricted to 6 mbgl. In midland areas, where the undulating topography is seen, the depth to water level generally varies from near ground level to 25 mbgl. The variation is mostly due to topographical variations, thickness of lateritic overburden etc. In areas where laterites are underlain by sedimentary aquifers of Tertiary age, the water level goes very deep, even to the extent of 55 mbgl. In highlands the depth to water level is in the range of few cm to 10 mbgl depending on the topography and thickness of overburden (weathered zone).
Groundwater Management
The National Water Policy of the Government of India states that the non conventional method for utilization of water such as through artificial recharge to ground water and traditional water conservation practices like rainwater harvesting need to be practiced to increase the utilizable water resources. The rainwater harvesting can be effected by in-situ-Harvesting and artificial recharge to ground water is the process of diverting the surface water into suitable geological formation. The common structures are percolation tanks, khadins, check dam/Anicut, sub-surface dams and injection wells. The ground water storage is the best method for water harvesting as it not only involves filtration of surface but is also safe from evaporation losses, natural catastrophes etc. Central Ground Water Board has implemented various artificial recharge schemes in Kerala like surface dykes, percolation tanks, and of top rainwater harvesting. Four sub-suface dams were constructed at Palghat district (Anaganadi, Bhabaji Nagar, Alanallur and Ottappalam), one at Ernakulam (Odakali), one at Kottayam (Neezhir) one at Quilon (Sandanadapuram) and two at Trivandrum district (Mampazhakara and Ayiolam). Central Ground Water Board has constructed two percolation tanks, one at Chirakulam of Kottayam district and another one at Kadapallam of Kasaragod district. Roof top rainwater harvesting schemes were implemented at two places viz. Ezhimala and Mayyilcolony of Kannur district. The artificial recharge structures have given satisfactory results and the groundwater condition in the area has improved considerably.
Rainwater harvesting is the viable solution in the monsoon rich state of Kerala. The common structures feasible for Kerala are sub-surface dykes, nala bunds, check dams. The traditional water conservation structures like natural ponds, reservoirs should be desilted and cleaned. Participatory watershed development programmes should be implemented in the State. Mass awareness programme on ground water conservation should be arranged at Panchayat level in all districts.
Other Resources:
Apart from rivers and wells sources like tanks, ponds, springs and surangams are also use in Kerala for providing water for drinking as well as irrigation. It is estimated that Kerala has approximately 995tanks and ponds having more than 15000 Mm³ summer storage. Natural springs occurring in the highland regions of Kerala state have the potential to be developed as good sources for drinking water supply and also for limited small scale irrigation, especially in remote and under developed areas. A total of 236 springs have been identified in the state. Kasaragode district in Northern Kerala has 510 special kind of water harvesting structure called Surangams which have >111pm discharge.
Major Irrigation Projects and Irrigation Status of Kerala
Karapuzha Irrigation Project:

Karapuzha Irrigation Project (KIP) is the first medium irrigation project in the Kabini Sub Basin of Cauvery river. Cauvery Water Disputes Tribunal (CWDT) has awarded 2.80 TMC of Cauvery water to Karapuzha. Karapuzha Irrigation Project is one of the 99 prioritised projects under Accelerated Irrigation Benefit Programme (AIBP). This project consists of an earthen dam with concrete spillway across Karapuzha river at Vazhavatta in Vythiri Taluk of Wayanad District for providing irrigation to a net ayacut of 5221 ha Cultivable Command Area (CCA) in Vythiri, Sulthanbathery and Mananthavady taluks of Wayanad District. Reservoir has a gross storage capacity of 76.50 Million Cubic Meter (MCM) with live storage capacity of 72.00 MCM.
This project was approved by Planning Commission in 1978 and administrative sanction was issued for ₹7.60 crore envisaging irrigation to Cultivable Command Area of 5,600 ha with ultimate irrigation potential of 8,721 ha. Karapuzha Irrigation Project was partially commissioned on 20th June 2010. Rectification of two main bottle necks were completed – (1) Rectification of breach in RB main canal at Edakkaravayal Ch. 7673 m-7888 m completed and is ready for water distribution from 2018 onwards (2) Rock portion in Padinjaraveedu branch canal near Ch. 330 m which off takes from the tail end of Left bank Main canal also cleared and connection made between the existing canal on both sides. From March 2017 onwards, water distribution through Left Bank Main Canal is carried out up to 15.30 km in trial basis. 1st phase of tourism project in Karapuzha was completed and the park and garden were opened to the public in June 2017. The present cost of the project is ₹560 crore (as per DSR 2014). The expenditure incurred up to August 31, 2018 is ₹322.69 crore. The total CCA created is 601 ha and the corresponding irrigation potential is 938 ha.
Karapuzha Irrigation Project, a medium irrigation project in Kabini sub basin of Cauvery river, was awarded 2.80 TMC of Cauvery water. The project was approved by Planning Commission in 1978 for ₹7.60 crore and was partially commissioned on June 20, 2010. The project has a Right Bank Main Canal (RBMC) with a length of 8,805 m and Left Bank Canal (LBMC) with a length of 16,740 m.
Achievements during 13th FYP:
A major setback to the Karapuzha Irrigation Project occurred due to Canal breach during floods in 2018 at Ch: 4,800m of Left Bank Main Canal reducing the ayacut area of LBMC from 245.17ha to 71.29ha. The rectification work of this major breach at Ch: 4,800 m is in progress and is proposed to be completed by November 2021. After completing these works the entire LBMC up to tail end ie; up to Ch: 16,740 m can be made functional for irrigating a total ayacut of 245.17 ha. During the floods in 2019, Canal Breach occurred at Ch:1,800 m of Kariambady Branch Canal which off takes from the tail end of the Right Bank Main Canal. The design of the structure has to be revised as this breached Canal was passing over an embankment of about 8m height and soil exploration work has been arranged in this reach. Land required for the construction of Ponginithody, Arimula, Vallipetta, Cheekkallura and Manivayal distributaries off-taking from the Right Bank Canal system are in the possession of the department and works in these reaches are proposed in 2021-22. This will provide irrigation to an additional ayacut of 459ha.
Muvattupuzha Valley Irrigation Project (MVIP):
The Muvattupuzha Valley Irrigation Project (MVIP), one of the major projects in Kerala envisages the utilisation of the tailrace discharge2 from the Moolamattom power House of the Idukki Hydro-Electric Project and the dependable runoff from the catchments of Thodupuzha river. MVIP was started in 1974 with an estimated cost of ₹20.86 crore and was approved by the Planning Commission in June 1983 at an estimated cost of ₹48.08 crore. The project was partially commissioned in 1994. Out of the total ayacut of 35,619 ha, an ayacut of 32,627 ha was created up to August 2018. 100 per cent works of main canal and branches and 90 per cent works of distributaries have been completed. Two works viz., construction of Ezhuthonipadam aqueduct over railway portion and Manjoor distributary pipeline crossing in railway portion has been completed this year. Water distribution will be commenced this year itself, and an ayacut of 1,335 ha can be utilised for irrigation. The estimated cost of the project based on 2015 Delhi Schedule of Rate (DSR) is ₹945.00 crore and the expenditure up to August 31, 2018 is ₹970.58 crore.
The Muvattupuzha Valley irrigation project envisages the utilisation of tailrace discharge from Moolamattom powerhouse of the Idukki hydroelectric project and the dependable runoff from the catchments of Thodupuzha river. Muvattupuzha Valley Irrigation project was commissioned on July 10, 2020 by completing the works of Main Canal, Branch Canals and Distributories except Edayar distributory and few reaches of Karikode Distributory. This Irrigation Project, started with an initial estimate cost of ₹20.86 crore, has Right Bank Main Canal (RBMC-28.339 km) and Left Bank Main Canal (LBMC-37.1 km). The branches of RBMC and LBMC have a total length of 57.154 km, while the distributaries have a total length of 213 km.
Progress of the project during the 13th Five Year Plan Period
• Completion of aqueduct at the railway crossing portion in Ezhuthonippadam, (between Ch.18,238m and 18,261m) created 796 ha, out of which 11ha was benefitted through Ettumanoor branch canal and 785 ha through Kurumulloor distributary
• Anicad East (Nadukkara) minor distributary (1620 m) length was completed and an ayacut of 196 Ha achieved during this year.
• With the completion of Madakkathanam Minor Distributary Painkulam aqueduct, an ayacut of 561 Ha was achieved during this year.
• With the completion of the lift of Koothattukulam distributary 450ha has been achieved during 2020-21. Koothattukulam lift was completed on May 28, 2020 and achieved an ayacut of 1,080 ha.Karikode 1st reach (0-1210m) provided an ayacut of 250ha.
• The envisaged ayacut of MVIP was 35,619ha (Gross) and 18,173ha (Net). As on date of commissioning, the total ayacut achieved from this project is 33,905 ha (Gross) and 17,342ha (Net). The cumulative expenditure incurred for the project as on March 31, 2021 is ₹1,100.88 crore.
Project Benefits: Main crops irrigated include paddy (3,364 ha), banana (2,126 ha), pulses (930 ha), tapioca (448 ha), ginger (14 ha), pineapple (790 ha), coconut (6,354 ha), arecanut (548 ha), rubber (3,868 ha), pepper (281 ha), vegetable (1,765 ha), coffee (16 ha), nutmeg (78 ha), turmeric (35 ha), cocoa (40 ha), miscellaneous trees (380 ha) and tubers (520 ha). This project also helps in desalination of low level paddy fields in Kottayam district and benefits the drinking water supply schemes of Idukki, Ernakulam and Kottayam districts. It helps in enhancing the ground water levels of nearby wells. Hindustan News Print Factory is one the beneficiary of the project. It also helps in the generation of hydel power of 10.5 MW.
Idamalayar Irrigation Project (IIP):
Idamalayar irrigation project (IIP) is a scheme for diverting water of Periyar river for irrigating 14,394 ha of cultivable lands in Periyar and Chalakudy basins. The work commenced in 1981 at an estimated cost of ₹17.85 crore. Main components of the project are – (1) A head regulator across the main canal at its starting point. (2) Canal system consisting of – Main canal (32.278 km), low level canal (27.25 km), and link canal (7.575 km).
Main Canal for a full length of 32.278 km had been completed. Works of low level canal is completed up to 15th km except at MC road crossing (Ch. 10,490 m to 10,599 m) and Railway crossing (Ch. 13,818.5 m to 13,879.50 m). After completing these two works, water distribution is possible upto 15th km of Low level canal which will benefit the agricultural and drinking water need of Angamaly Municipality and Nedumbassery Panchayat. Construction works of link canal is completed from Ch. 445 m to 608 m. The total ayacut achieved is 3,048 ha and the expenditure up to August 31, 2018 is ₹350.83 crore.
Idamalayar irrigation project, which commenced in 1981 with an estimated cost of ₹17.85 crore, aims at irrigating 14,394 ha of cultivable lands in Periyar and Chalakudy basins. Main canal works were completed for the full length of 32.278 km. The length of the Low level Canal is limited to 15 kilometers, wherein there were two bottlenecks – MC road crossing and railway crossing.
Some of the notable achievements of the project during the 13th FYP
• In 2020-21, Push Through construction was carried out for clearing the bottleneck at the MC road crossing portion in the Low Level Canal, the first of its kind in the history of Irrigation Department. This helped in augmenting drinking water and providing agricultural benefits to Nedumbassery panchayat. An additional ayacut of 1,035 ha was achieved subsequent to the push through construction.
• 99.5 per cent of Low Level Canal (LLC) has been completed. The construction of balance 74 m of the proposed low level canal includes a railway crossing work. Completion of MC road crossing and the above said stretch of the canal facilitated water distribution upto Ch.12540m, thereby meeting the drinking water and agriculture needs of Nedumbassery Panchayat.
• The land acquisition process for the Kanjoor Thekkumbhagom branch canal is in progress. SIA study for 1.333 KM has been completed.
• The construction of flush escape at the tail end of Low Level Canal at Ch14,623 is pending due to delay in land acquisition.
• DPR for inter basin transfer of water from Periyar basin to Chalakkudy basin by means of link canal has been submitted to Government.
• An ayacut of 128 Ha and 396 Ha has been achieved from Manappatuchira and from completion of link canal respectively
• The financial expenditure upto March 2021 is ₹507.99 crore and the gross physical achievement is 4,195 Ha.
Banasurasagar Irrigation Project:
Banasurasagar Irrigation Project is the second irrigation project in Wayanad District. This Irrigation Project is in the Karamanthodu basin which is a tributary of Panamaram river. The project commenced in 1979 to irrigate an area of 2,800 ha (net) agriculture land for the second and third crops in two taluks of Wayanad District.
The main canal is 2.73 km long and there are two branch canals – Padinjarathara branch canal having a length 9.030 km and Venniyode branch canal with a length of 5.390 km. Of the total main canal, 2,360 m canal works were completed. Works of both branch canals – Padinjarathara and Venniyode are in progress. The revised estimate of the project as per 2016 DSR is ₹165.98 crore and the total expenditure up to August 31, 2018 is ₹59. 18 crore. Table 1, Table 2.
The overall performance of the major and medium irrigation sector during the initial years was not encouraging. The cumulative area brought under irrigation through major and medium irrigation projects is 29346 hectares (gross). The details of the progress of implementation of ongoing projects as on March 2010 are given here.
Banasurasagar Irrigation project, in the Karamanthodu basin, envisages to irrigate an area of 2,800ha (net) agriculture land for the second and third crops in two taluks of Wayanad district. It consists of a main canal having a length of 2.73km and two branch canals - Padinjarathara (9.030km) and Venniyode (5.390km).
Achievements in the 13th Five Year Plan
• Diversion Chamber completed between Padinjarathara and Venniyode branch Canal
• 15 per cent of the work of Venniyode Branch Canal (Ch:20m to Ch:570m) completed and 35 per cent of Ch:4,325m to Ch:4,620m work completed.
• Kappumkunnu distributary Ch:3,005m to Ch:3,205m work completed.
• Venniyode Branch Canal Ch: 570m to 1715 m work is under progress. 18 per cent of the work completed.
• Kappumkunnu distributary Ch:1,480m to 1,565m work is under progress. 40 per cent of the work completed.
• In 2019-20 Re investigation of distributaries, reformation of inspection road near diversion chamber works were completed.
• 95 per cent of the Investigation works of distributaries completed
Flood Management Programmes in Kuttanad: Major flood management works in Kuttanad include strengthening and raising the outer bunds of padasekharams and allied works such as construction of motor thara, shed, sluice, and pipe and box culvert. Notable achievements could be attained in flood control activities through Government of India approved schemes KEL I, KEL II, KEL III and KEL IV thereby protecting 574.83ha, 3,262.91ha, 2,818ha and 5,834ha respectively.
Achievements in the 13th Five Year Plan
1. Flood Management Programme (FMP) - Mitigation of flood in Kuttanad region-Phase-1 (Group 2-5, 7-8,10-19), 231 padasekharams in kottayam, Alappuzha Districts. The scheme includes flood management works of 231 padasekharams in Kottayam and Alappuzha districts. By completing the outer bunds of 46 padasekharams, it could be possible to conduct second paddy cultivation and agriculture in these padasekharams, and thereby increasing agricultural production. The major achievements include the following:
• Protected area - 2,818 Ha
• Total length of completed bund -128.636 Km
• Total No. of Motor thara /shed constructed- 61 Nos
• Total No. of Sluices Completed -68 Nos
• Total No. of Box / pipe culverts constructed -36 No
2. Mitigation of flood in Onattukara region comprising of 12 Watersheds in Kerala. The major achievements include the following.
• Total area protected- 5834ha
• Total length of bunds completed- 33.2km
• Total No of motorthara/shed constructed-1no
• Total No of culverts constructed- 11nos
• Total No of foot bridge constructed- 17 nos
• Total No of Vented cross bar (VCB)- 3 no
3. Mitigation of flooding 397 padasekharams of Kuttanad Taluk and 14 padasekharams of Veeyapuram Panchayat.By completing this scheme it is possible to do paddy cultivation twice in a year in all the above padasekharams. The major achievements include the following:
• Total area protected - 3871.75 Ha
• Total length of bunds completed -177.64 Km
• Total No of motorthara /shed constructed - 166 no
• Total No of Sluices Completed - 29 nos
• Total No of Box/Pipe culvert constructed- 24 no
• Total No of Thoombu - 587 nos
4. Reconstruction of bund at Puthenarayiram Padasekharam in D block: This Padasekharam in Pulinkunnu Grama Panchayath of Kuttanad Taluk, having an area of 211 ha, experienced a breach in the western bund during 2015 and 2016 because of high tides. Latest technology of precast pile and slab was adopted at the breached portion. Three layers of precast piles were driven in to the ground and connected by Tie Beams. Precast slabs were inserted in between precast piles and the bund was made by filling kayal clay in between piles. To reinforce this, 120 metre long new bund and extra berm was constructed using three rows of coconut piles. Kayal clay was used to fill the berm along the inside and outside of the breached portion. In 2020-21, 42 new works were taken up, which includes construction of outer bund for a length of 47.09 KM and desilting of thodes for a length of 50.84 KM. Out of the 42 works 23 were completed.
5. Modernisation of Thanneermukkom Barrage: Thannermukkam barrage, a Salt water barrier structure located at Thannermukkam, is built at the narrow region of Vembanad lake. Construction of bridge was (3rd phase-middle portion) completed with 28 stainless steel shutters and allied lifting mechanisms and opened for traffic on July 31, 2018. Radial gates and hydraulic system of 46 feet lock (14M) had 62 old shutters in the 1st and 2nd phase were replaced with stainless steel shutters. The work related to the hoisting mechanism of these shutters are completed, Renovation of 20 feet and 30 feet locks has been completed. After the completion of modernisation of Thannermukkam barrage, the flood water can easily drain out towards the estuaries.
6. Improving the efficiency of Thottapally Spillway: Thottapally spillway was constructed to expel the flood water to sea from Kuttanad areas. The actual design capacity of Thottappally spillway is 1800 cubic metre per second, but it got reduced to 600 cubic metre per second because of the reduced width of estuary from 380m to 150m. This reduction in the width of estuary was because of the formation of sand bars and casuarina plantation. The reduced width at the mouth, having decreased the efficiency of draining out flood waters in to sea, became a crucial factor for the floods in 2018. Therefore, to reinstate the width of 360m at the estuary mouth, 2,42,831.25 cubic meter of sand and obstructions were completely removed before July 23, 2020.
Kerala Water Resources Information System (Kerala-WRIS): Kerala-WRIS, is a web enabled platform wherein data related to water and its allied sectors are integrated, has been developed utilising funds under the Rebuild Kerala initiative (RKI). Kerala-WRIS acts as a single authoritative digital platform with specific modules such as weather, water Availability, water demand, water budgeting and auditing and the software development of all these modules have been completed.
Flood Forecasting and Early Warning System (FFEWS): Development of a system for coordinated operation of reservoirs integrated with flood forecasting and early warning system for Periyar river basin is progressing under National Hydrology Project (NHP). First Deliverable, viz ‘Submission of inception Report’ has been completed and second Deliverable, viz. ‘Report on Optimized RTDAS Network’ has been received and its evaluation is progressing. Establishing a
Real Time Data Acquisition System (RTDAS): Establishing of RTDAS progressing under NHP comprises of real time stations, such as 99 Tipping Bucket Rain Gauges (TBRGs), 56 Radar Level Sensors (RLSs) and 13 Automatic Weather Stations (AWSs). The contract value of the project is ₹12.50 crore. Installation of 91 Tipping Bucket Rain Gauges, 43 Radar Level Sensors and 12 Automatic Weather Stations has been completed.
Irrigation Status: As per the assessment of the Directorate of Economics and Statistics the net irrigated area in the state as on March 2010, is 3.86 lakh ha. and the gross area irrigated is 4.54 lakh ha. The net area irrigated has declined from 3.99 lakh ha during 2008-09 to 3.86 lakh ha in 2009-10. Only 16.34 per cent of the net cropped area is irrigated. The percentage of net area irrigated to net area has declined and percentage of gross irrigated area to gross cropped area records a slight increase during the year compared to the last year. During 2009-10 the net irrigated area registered a decline of 10.75 per cent and gross irrigated area by 0.64 percent compared to the previous year. During 2009-10, among the crops, paddy tops among the major crop supported by irrigation. It accounted for about 37 per cent followed by coconut (33%), banana (8%), arecanut (8%) and vegetables (4%) is given here.
The source-wise area irrigated as on March 2013 is given here . As per the assessment of the Directorate of Economics and Statistics the net irrigated area in the state as on March 2013, is 3.96 lakh ha. and the gross area irrigated is 4.58 lakh ha. There is a decrease of 3.2 percent in the net irrigated area of the state in compared to the previous year of 2011-12. Gross irrigated area also decreased 6.7 percent during the period. Gross irrigated area to Gross Cropped Area in the period is 17.67 percent. During 2012-13, among the crops, coconut tops among the major crop supported by irrigation. It accounted for about 36 percent followed by paddy 32 percent, banana 10 percent, arecanut 8 percent and vegetable 4 percent. Details are given here. There has been a good progress in irrigated area under vegetable cultivation during the year and also an increase in the area under irrigation for banana cultivation compared to the previous year.
The source wise irrigation status as on March 2014 and 2015 are given here[PDF1, PDF2]. As per the assessment of the Directorate of Economics and Statistics, the net irrigated area in the State as on March 2015, is 4.14 lakh ha. and the gross area irrigated is 4.69 lakh ha. The percentage of increase is not significant compared to the previous year. During 2014-15, the percentage of Gross Irrigated Area to Gross Cropped Area was 17.80. The crop which benefitted the most during the period is coconut. It accounted for about 35.18 percent followed by paddy (32 percent), banana (10.19 percent), arecanut (7.2 percent) and vegetable (5.21 per cent). The details are given here. There has been an increase in irrigated area for vegetable cultivation during 2014-15 compared to the previous year. Source-wise net irrigated area in 2017-18 is given here.
Net Area Irrigated (Source-wise) 2017-18(in ha) in given here.
The net irrigated area has fluctuated during the period 2015-16 to 2017-18. The net irrigated area that was 4.13 lakh ha in 2015-16, declined to 3.77 lakh ha in 2016-17 and showed an increase of 4 per cent to 3.92 lakh ha in 2017-18. During the period under review, wells contributed the major source of irrigation benefiting 1.23 lakh ha followed by irrigation canals which served an area of 0.76 lakh ha.
The gross irrigated area increased from 4.83 lakh ha in 2015-16 to 4.97 lakh ha in 2016-17 and further showed an increase of 8.4 per cent to 5.39 lakh in 2017-18. Details of Gross Irrigated area and the crops benefited out of this are given here. Gross Area Irrigated (Crop-wise) are given here. Source-wise net irrigated area in 2018-19 is given here.
Net Area Irrigated (Source-wise) 2018-19(in ha) in given here.
The net irrigated area continues to expand over the period from 2016-17 to 2018-19. From 3.77 lakh ha in 2016-17, it increased to 3.92 lakh ha (2017-18) and to 4.04 lakh ha (2018-19). The main sources of irrigation are small stream, pond, well, bore well, lift, and minor irrigation. Wells provide irrigation to 1.24 lakh ha, whereas all other sources together (bore well, lift and minor irrigation, rivers, lakes, etc.) irrigates 1.47 lakh ha. The gross irrigated area has declined from 5.39 lakh ha (2017-18) to 4.89 lakh ha (2018-19). Details of gross irrigated area and the crops benefitted are given here. Table II.
Even though coconut is the most irrigated crop, the extent of increase in area under irrigation is nominal i.e., the irrigated area has risen from 1.58 lakh ha (2017-18) to 1.59 lakh ha (2018-19). This should be viewed in tune with the area under coconut cultivation which continued to remain the same at 7.60 lakh ha during 2017-18 and 2018-19. But, the extent of irrigated area under paddy cultivation, the second most irrigated crop, shows a steep increase from 1.31 lakh ha (2016-17) to 1.45 lakh ha (2017-18) and to 1.54 lakh ha (2018-19). This increase in the irrigated area may be due to the increase in area under paddy cultivation.
Acknowledging the fact that the net irrigated area reflects an increasing trend over the years, the decline in the gross irrigated area from 5.39 lakh ha (2017-18) to 4.89 lakh ha (2018-19) also needs to be cited. It may be inferred that this decline may be either due to non provision of irrigation facilities for the second crop or because of the absence of second crop itself. The decline in the total cropped area from 25.79 lakh ha (2017-18) to 25.68 lakh ha (2018-19) underlines the above point. Details on net irrigated area (source-wise) in 2019-20 is given here. Net Area Irrigated (source-wise)- 2019-20 is given here.
The net irrigated area showed an increase over the period from 2017-18 to 2019-20, from 3.92 lakh ha (2017-18) to 4.04 lakh ha (2018-19) which further increased to 4.09 lakh ha (2019-20). But the gross irrigated area after having declined from 5.398 lakh ha (17-18) to 5.153 lakh ha (18-19), did not fluctuate much with the area remaining at 5.156 lakh ha in 2019-20. Details of gross irrigated area and the crops benefited are given here. Table II.
Though coconut and paddy continued to be the major benefited crops even in 2019-20, the irrigated area of both these crops has declined than the previous year. Gross irrigated area under paddy declined from 1.54 lakh ha (2018-19) to 1.50 lakh ha (2019-20) and the irrigated area of coconut fell from 1.59 lakh ha (2018-19) to 1.58 lakh ha (2019-20). The reduction in area under wetland paddy from 1.98 lakh ha (2018-19) to 1.91 lakh ha (2019-20) needs to be mentioned in this context. In 2019-20, the area under banana cultivation as well as the irrigated area showed an increase. While the area under banana increased from 0.52 lakh ha (2018-19) to 0.60 lakh ha (2019-20), the irrigated area of banana increased from 0.44 lakh ha (2018-19) to 0.52 lakh ha (2019-20). Vegetables also had a nominal increase in their irrigated area from 0.30 lakh ha (2018-19) to 0.31 lakh ha (2019-20). There is no change in the percentage of gross irrigated area to gross cropped area (20 per cent) in 2018-19 and 2019-20.
As per the assessment of the Directorate of Economics and Statistics the net irrigated area in the State is 3.897 lakh ha and gross irrigated area is 5.215 lakh ha. The details of net irrigated area (source wise and district wise) during 2020-21 are shown below:
Net Area Irrigated (Source wise) (in Ha.)
|
Source
|
2018-19
|
2019-20
|
2020-21
|
Government canals
|
82975
|
85358
|
81801.33
|
Private canals
|
513
|
635
|
694.53
|
Tanks
|
49376
|
46779
|
43434.58
|
Wells
|
124020
|
117875
|
114121.37
|
Other sources
|
147512
|
153455
|
149741.87
|
Total
|
404396
|
404102
|
389793.68
|
Gross irrigated area
|
515388
|
517642.04
|
521478
|
Net area irrigated to net area sown (%)
|
20
|
20
|
19.50
|
Gross irrigated area to gross cropped area (%)
|
20
|
20
|
20.30
|
Irrigated area under paddy to total irrigated area (%)
|
30
|
29
|
30.61
|
Source: Directorate of Economics & Statistics Gok
|
Net Area Irrigated (Source Wise) - 2020-21 is given here.
The net irrigated area shows a decreasing trend from 4.043 lakh ha (2018-19) to 3.897 lakh ha in (2020-21). But, the gross irrigated area showed a marginal increase from 5.153 lakh ha (2018-19) to 5.215 lakh ha (2020-21). Details of gross irrigated area and the crops benefitted are given here.
Gross Area Irrigated (Crop-wise) (in ha.)
|
Crops
|
2018-19
|
2019-20
|
2020-21
|
Paddy
|
154138
|
150009
|
159639.54
|
Vegetables
|
30112
|
31256
|
28844.56
|
Coconut
|
159492
|
158584
|
158834.38
|
Areca nut
|
33353
|
33093
|
31902.86
|
Nutmeg
|
19840
|
19861
|
19861
|
Clove
|
113
|
110
|
121
|
Banana
|
44820
|
52044
|
52365.64
|
Betel leaves
|
236
|
252
|
252.43
|
Sugarcane
|
1012
|
950
|
920.73
|
Others
|
72272
|
71484
|
|
